Zurich Airport railway station
Información

location_on Location: Zurich, Switzerland

date_range Date: 2019/2020

architecture Contractor: ARGE FF Flughafen (Walo Bertschinger AG, C. Vanoli AG and Carlo Vanoli AG)

The four tracks of Zurich Airport's underground railway station have been renovated and lowered without interrupting traffic.

Between October 2019 and March 2020, Swiss Federal Railways (SBB) undertook the renovation of all four tracks at Zurich Airport station. One of the main objectives of the project was to lower the tracks to make the trains accessible to wheelchair users without having to modify the tunnel structure. The solution was to replace the concrete sleepers on the tracks, which were showing signs of damages after 40 years of operation.

Description


With its high tensile and compressive strength as well as high durability, Ductal® Overlay enables an economical use of materials. Only small quantities of material are required to produce very robust and durable construction elements. For example, it was possible to reduce the height of the new sleeper blocks by 4 to 5 cm and to achieve support points in these areas of only 10 to 15 cm in height.

Optimization

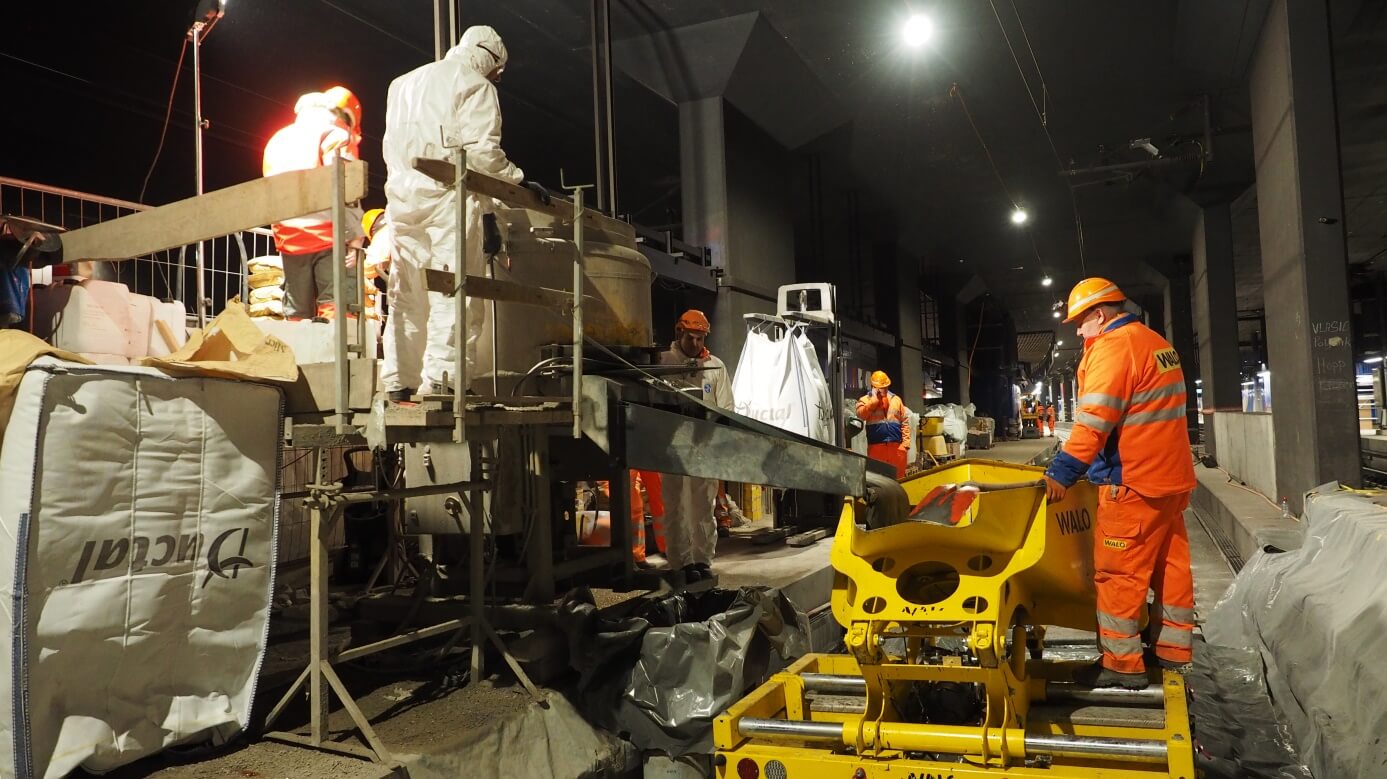

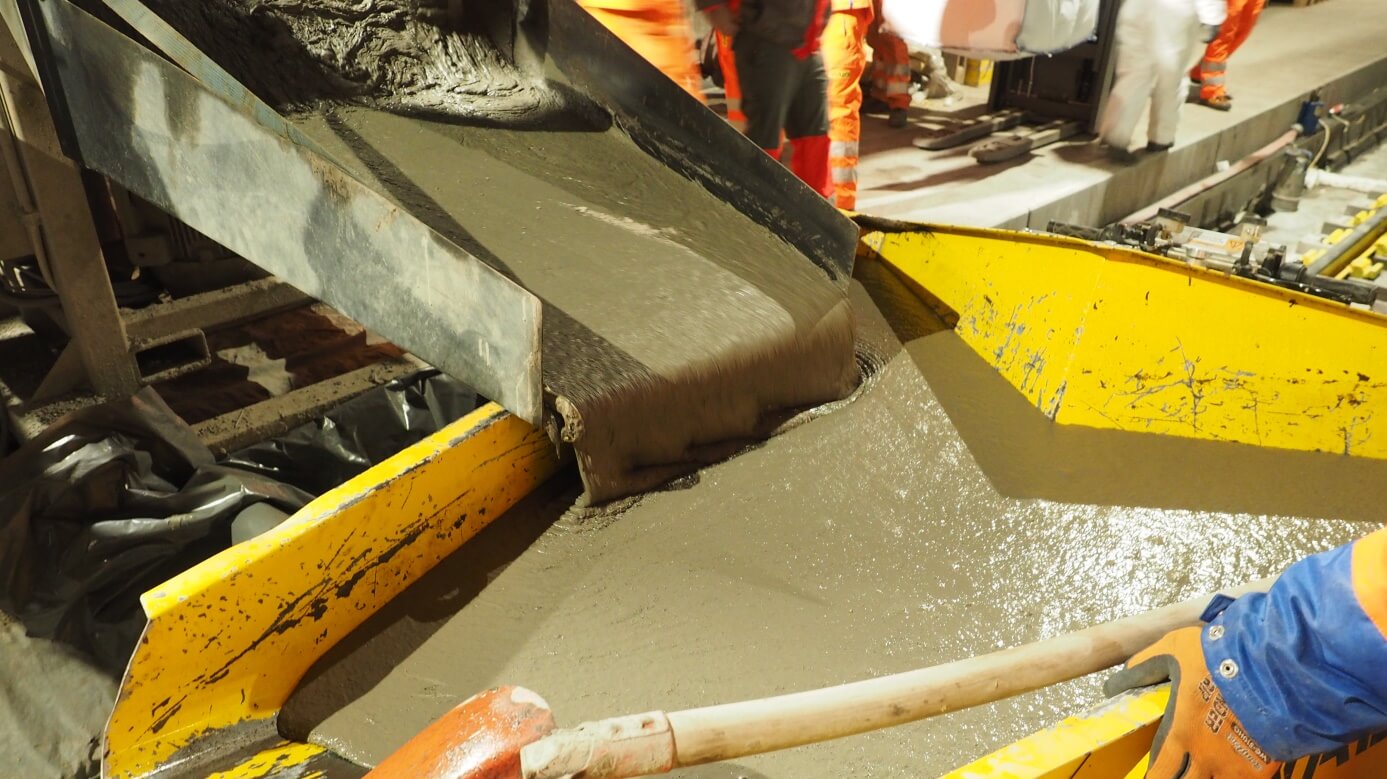

Operation of the station continued throughout the construction phase. Due to the short period of closure (four weeks per track), the ARGE FF Flughafen consortium (Walo Bertschinger AG, C. Vanoli AG and Carlo Vanoli AG) worked in three shifts under the leadership of Walo Bertschinger AG. Delivery of the materials could only be made by rail during the four hours of nighttime closure. As the construction site was not accessible to lorries, the production of concrete was a real challenge. Walo organized a local production of the UHPC at the end of the track and developed an autonomous wagon to deliver the product direct to every block to be build

Application


Logistics was one of the biggest challenges of this project. All movements of materials had to be planned precisely in advance. Due to the limited space available, it was not possible to store large reserves on the construction site. The cooperation between Walo and Holcim in this phase was very constructive.

Challenge


Galería


Descubre nuestros proyectos

The Gardiner Expressway structure rehabilitation is part of the City of Toronto’s Strategic Rehabilitation Plan in order to rehabilitate and keep the structure in a safe and operable condition for now and the future.

The four tracks of Zurich Airport's underground railway station have been renovated and lowered without interrupting traffic.

Mosquito Creek Bridge was in need of a rehabilitation due to its age and deterioration to bring it up to modern seismic standards. This bridge was the first bridge constructed in Canada to use pre-stressing, completed in 1952 andis located in North Vancouver, near Marine Drive and Fell Ave.

Eastbourne Arndale Shopping Centre is a £85 million redevelopment including 22 retail units, seven restaurant units, a multiscreen cinema and a significant extension to the multi-storey car park.

The concrete of the abutments and central pillars of the Grafstal road bridge (municipality of Lindau) above the A1 motorway showed damage due to chloride infiltration.

Dominie Creek bridge lies on ancestral territory where Caltrans and Tolowa Dee-ni’ Nation worked together to replace the old dilapidated box culvert structure. The finished bridge has an emblem of spawning salmon at each abutment barrier wall which was inspired by the locations salmon and trout spawning.

The Arlington Memorial Bridge is located in Washington DC which carries traffic over the Potomac River. The original structure used masonic decorative features which gives this bridge an iconic look.

Put into service in 1975, the Caderousse dam is a storage reservoir on the Rhône River in Vaucluse, France.

A structure that symbolizes US bridge engineering of the 1930s, the Pulaski Skyway, which links Newark to Jersey City has been partially closed as it undergoes a considerable rehabilitation - the largest in its history. The project was a perfect opportunity for the Federal Highway Administration (FHWA) and the New Jersey Department of Transportation (NJDOT) to take full advantage of...

The rehabilitation of Mauves-sur-Loire bridge consists in substituting the existing deck (3,500 m²) made of brick vaults with a thin deck made of thin precast UHPFRC slabs. The main objective of the project is to upgrade this historic landmark by increasing its bearing capacity and allowing the addition of cantilevered footbridges.
